Tags

Nags Head Nourishment Project Set to Start

CSE, working with the Town of Nags Head and Great Lakes Dock and Dredge (GLDD) is pleased to announce that a 4.6 million cubic yard beach restoration project is set to begin pumping in June. GLDD crews have already started to mobilize equipment to the site and CSE staff are geared to assist with construction. We will post periodic updates on our website and will assist the Town with daily updates. The Town’s beach nourishment website is found here Feel free to contact us or the Town with any questions.

Nags Head Overflight 23 Feb 2011.

CSE’s Coastal Erosion and Solutions - A Primer (2nd Edition) Now Available

[caption id=”attachment_323″ align=”alignright” width=”255″ caption=”CSE's Coastal Erosion and Solutions - A Primer”]CSE's Coastal Erosion and Solutions - A Primer[/caption]

We are pleased to announce that the 2011 edition of CSE’s Primer is now available.  Following its debut in 2003, the updated version includes 12 more pages and expanded discussion of:

  • Sea-level rise
  • Limits of the littoral zone
  • Hurricane impacts and recovery
  • Measurement of erosion
  • Soft-engineering solutions

Single copies of the high-quality printed version (40 pages) are available by request.  A low-resolution version (PDF, 4.6MB) may be downloaded and used without restriction (please cite the work as appropriate).  Bulk copies for use in university classes are available at cost.

Coastal Erosion and Solutions (2nd Edition) includes a new section Conventional Wisdom & Common Misconceptions which will provide a new perspective on your favorite beach.

CSE thanks a growing number of colleagues who have adopted the Primer as a supplementary text for introductory courses in coastal engineering and coastal processes.  Comments are welcome.

CSE improves marine measurement capabilities

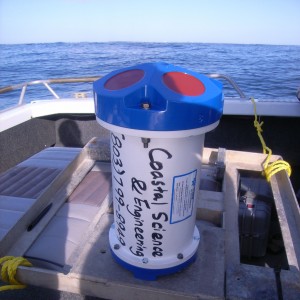

[caption id=”attachment_317″ align=”alignright” width=”300″ caption=”CSE's Teledyne-RDI Acoustic Doppler Profiler, on RV Congaree River”]Teledyne-RDI Acoustic Doppler Current Profiler[/caption]

CSE has recently acquired a Teledyne-RDI Acoustic Doppler Current Profiler (ADCP). The Workhorse Sentinel model provides real-time and stand-alone measurements of currents, waves, and suspended material in multiple layers of the water column. The high frequency and high accuracy data can be used for flushing studies, erosion analysis, shoaling analysis, wave measurements, and hydrodynamic model calibration. CSE can collect real-time current data from the R/V Congaree River, or deploy the instrument in a variety of settings to collect autonomous data. For questions about the capabilities of CSE’s new ADCP, contact Steven Traynum (straynum@coastalscience.com).

New pictures of the RV Congaree River and crew

[caption id=”attachment_275″ align=”alignright” width=”300″ caption=”Nearshore hydrographic data collection in RV Congaree River”]Near-shore hydrographic data collection in RV Congaree River[/caption]

New pictures of the RV Congaree River and her crew have been added to our Data Collection page!
RV Congaree River is CSE’s 24 foot custom welded aluminum-hull jetboat, powered by an 8.1L GMC inboard engine. Originally designed to handle whitewater rapids in the Hells Canyon area of the Snake River, her extremely shallow draft and high-performance characteristics allow CSE’s captain, Philip McKee, to collect bathymetric data much closer to shore and under a much wider range of conditions than possible with conventional boat designs.

CSE Celebrates Bogue Banks - Ten Years Later

Ten years ago, CSE was invited by Carteret County to assist the Beach Preservation Task Force in developing a shoreline erosion assessment and beach restoration plan for Bogue Banks.  The impetus for the plan was a succession of five hurricanes between 1996 and September 1999.  Within four months, CSE completed the first comprehensive beach and inshore survey of the island, located several viable sand borrow areas, and prepared a preliminary design and estimate of construction costs for beach nourishment along 16.8 miles encompassing the towns of Pine Knoll Shores (PKS), Indian Beach and unincorporated Salter Path (IBSP), and Emerald Isle (EI).

By April 2002, Phase I of CSE’s three-phase, $32 million plan was complete along Pine Knoll Shores and Indian Beach/Salter Path.  It was followed one year later by Phase II encompassing east and central Emerald Isle.  CSE also prepared the Phase III concept plan and preliminary design for realignment of the Bogue Inlet channel and restoration of western Emerald Isle.  Final design and implementation of Phase III was completed by another firm in 2005.

The Carteret County beach restoration project was pioneering in a number of ways:

  • Only the second project in North Carolina to utilize offshore borrow areas and ocean-certified hopper dredges.
  • Largest locally sponsored nourishment project (Phases I and II involved no state or federal funds) in North Carolina
  • One of the largest nourishment projects ever in the United States.

The keys to rapid implementation of Phases I and II of the County plan were timely field data collection, preparation of a credible and understandable (to the community) plan, close coordination with regulatory and resource agencies during the NEPA/NCEPA process, and strong local leadership in support of the plan. Since the first phase of the County beach restoration project was completed (April 2002), there have been a total of 11 nourishment events (~10.3 million cubic yards) along Bogue Banks.  This is the equivalent of ~80 cy/ft added along the entire length of the island.

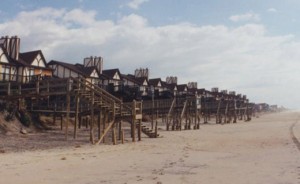

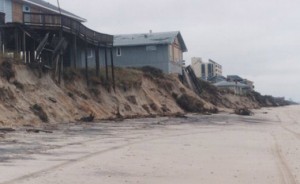

Indian Beach (before)

Indian Beach (before above, after below)

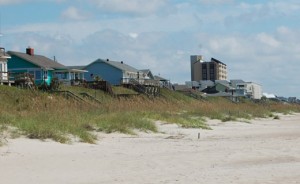

Indian Beach (after)

Pine Knoll Shores (before)

Pine Knoll Shores (before above, after below)

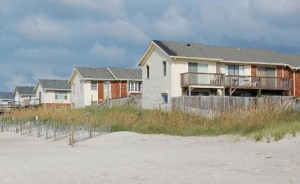

Pine Knoll Shores (after)

As the before and after photos show, Bogue Banks today has a much healthier beach; property owners have not had to rebuild dune walkovers or scrape the beach each year; and new vegetation is stabilizing the foredune.  The plan that CSE laid out for Bogue Banks in 1999 has stood the test of time.  Over 85 percent of the nourishment volumes placed between 2001 and 2007 along Pine Knoll Shores, Indian Beach/Salter Path, and Emerald Isle remained in place as of 2008.

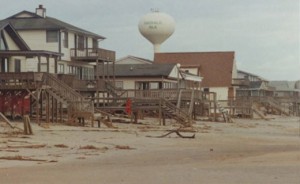

Emerald Isle (before)

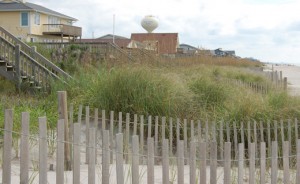

Emerald Isle (before above, after below)

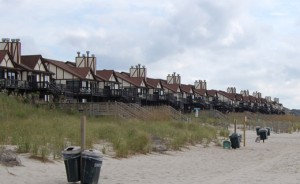

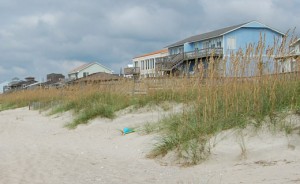

Emerald Isle (after)

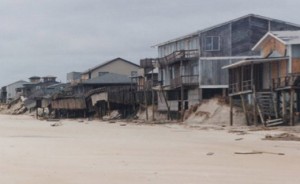

Emerald Isle (before)

Emerald Isle (before above, after below)
Emerald Isle (after)

CSE is proud to have played a central role in restoring the Bogue Banks beach, reducing storm damages, and enhancing the tax base of three municipalities on the island.  We thank county officials and citizens of Bogue Banks for their support over the past decade.

Emerald Isle (before)

Emerald Isle (before above, after below)
Emerald Isle (after)

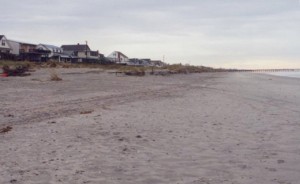

Atlantic Beach (before)

Atlantic Beach (before above, after below)

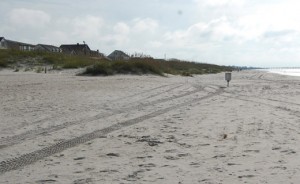

Atlantic Beach (after)

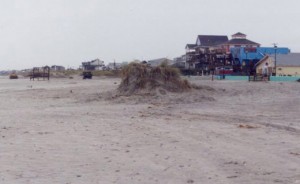

Atlantic Beach (before)

Atlantic Beach (before above, after below)
Atlantic Beach (after)

CSE Completes Another Waterfront Project

[caption id=”attachment_64″ align=”alignright” width=”210″ caption=”Washington, NC Waterfront Promenade and Marina”]Washington, NC Waterfront Promenade and Marina[/caption]

CSE recently completed the design and permitting for the Washington (NC) Waterfront Promenade and Marina.  This municipal project on the Pamlico River added 48 wet slips to accommodate yachts up to 80 feet long.  Services provided by CSE included design of wastewater disposal and marine power systems, fixed timber docks and a ferry landing.

Construction is finished and the project is fully operational, making the Washington Waterfront one of the most attractive destinations for boaters along the western shore of Pamlico Sound.

Click here for more information on CSE Waterfronts and Marinas.

CSE Working with Sasaki Associates

For over 25 years, CSE has assisted Sasaki Associates (Boston) with coastal engineering in connection with large waterfront developments.  Some recent projects include wave and flow modeling for the Daniel Island Marina in Charleston (SC) and a flushing study for a proposed marina in Panama City (FL).

For the Daniel Island Marina, CSE collected detailed bathymetry in the lower Wando River and measured tides, currents, turbidity, and discharge within the system using our complement of acoustic current meters, pressure gauges, and synoptic sampling gear.  Time-series field data were used to calibrate the hydrodynamic model, RMA2, under USACE’s Surface Water Modeling System (SMS).  Once calibrated, RMA2 was used to simulate flows and water levels under extreme events.  Waves were calculated for 10-, 50-, 100-, and 500-year events for mid-tide and peak-tide conditions.  The goal was to provide the marina designers with the range of hydrodynamic forces for the setting so they could optimize the design of piles and docks under Category 2 or Category 3 storm conditions.

Daniel Island Marina

Daniel Island Marina Report Excerpt (pdf)

Isle of Palms Renourishment Completed Ahead of Schedule

[caption id=”attachment_26″ align=”alignleft” width=”300″ caption=”Isle of Palms - before nourishment”]Isle of Palms - before nourishment[/caption]

Isle of Palms is a 7-mile long, 1-mile wide barrier island off South Carolina’s coast in Charleston County. It is a blend of almost 5,000 fulltime residents, and 20,000 to 50,000 investment owners and visitors. The Wild Dunes Resort occupies 1,500 acres on the northeast end of the island, which includes two 18-hole Fazio golf courses.

A July 2007 survey indicated that the condition of the beach at the northeast end was worse than at any time since May 1984. Sand volumes in this area had dwindled to an average of only 99 cubic yards per linear foot at low tide compared to the 1984 average of 123 cubic yards per linear foot, and even a peak in the late 90’s at 165 cubic yards per linear foot. The result was basically loss of any dry beach, and direct encroachment of the water on upland property. Erosion was so severe that emergency sand bags had been placed along nearly all properties in that area to protect building foundations. However, the bags have not been totally effective.

CSE was hired to design and implement a beach renourishment project for this end of the Isle of Palms, to include a systematic and thorough removal of all sand bags in the project area. The plan called for up to 885,000 cubic yards of beach quality sand to be placed on the beach via hydraulic dredge, and removal of some 9,000 sand bags. Weeks Marine, Inc. was contracted for the dredging, and CSE staff worked on the beach with them to analyze and dispose of the sand bags.

[caption id=”attachment_27″ align=”alignright” width=”300″ caption=”Isle of Palms - after nourishment”]Isle of Palms - after nourishment[/caption]

The window of time permitted for the project was May 15, 2008 through July 31, 2008. Weeks Marine mobilized and began work on May 15th. The dredging operation ran 24-hour, 7 days a week, with sand bag removal running simultaneously roughly 9 hours a day for 6 days a week. Fork lifts and bobcats were on the beach lifting and disposing of sand bags, as staff slit and analyzed each bag’s content for appropriate disposal. Offshore, Weeks’ hydraulic dredge, the R.S. Weeks, pumped beach-quality sand from pre-approved borrow areas through 30-inch pipelines onto the shore, ultimately covering 10,200 linear feet of beach. All permit requirements for environmental concerns were met, with certified turtle teams monitoring the beach daily and successfully relocating 3 turtle nests during the project time frame.

Weather conditions during the project period were ideal, with no major delays interrupting either offshore or onshore operations. One minor glitch did occur, however, in June, when a loud rattling noise came from the sand pipe on the beach and a ten-inch cannonball spilled out from the pipe onto the sand. CSE engineer and Project Manager for the Isle of Palms project, Brooke Fassnidge, was on the beach with Weeks personnel at the time and immediately cleared the area for the appropriate emergency and state officials to assess the situation. State Historian Richard Hatcher identified the cannonball as a Civil War munition that had been resting on the ocean floor for over 100 years. It was initially transported to Fort Sumter for cleaning and preparation for final transport to the SC Historic Preservation Office.

Substantial completion of all operations was achieved on June 27, 2008, over a month ahead of schedule. Final completion was achieved on July 15th, still 2 weeks ahead of schedule. This was in no small part due to the dedicated and interdisciplinary team involved, with coordination and daily oversight by Brooke Fassnidge and Steven Traynum of CSE, and Doug Nelson of Weeks Marine. Isle of Palms was able to provide a wide, sandy beach to visitors for the better part of their summer season. A final total volume of 847,000 cubic yards of sand was placed on the beach, and a total of 9,401 sand bags removed. Environmental impacts were kept to a minimum, and plans for restoration of the famed 18th hole of the Links Golf Course are currently underway. Cannonball notwithstanding, it was a win-win project for all concerned!

CSE Completes Renourishment of Arcadian Shores

[caption id=”attachment_39″ align=”alignright” width=”300″ caption=”Enjoyment of the beach continues while the nourishment takes place (19 March 2008)”]Enjoyment of the beach continues while the nourishment takes place (19 March 2008)[/caption]

Arcadian Shores is a section of South Carolina’s Grand Strand between North Myrtle Beach and Myrtle Beach. It is home to Hilton Hotel Resort, Kingston Plantation, and several major residential towers. While the cities immediately north and south are part of a 50-year federal beach nourishment project, Arcadian Shores is not included. However, Horry County, which has jurisdiction over Arcadian Shores, with funding assistance from the state of South Carolina, has taken the initiative to maintain and improve the beach.

Ten years ago, Horry County was able to “piggyback” the first nourishment of Arcadian Shores as the contractor was completing the project at Myrtle Beach. With a scheduled renourishment of Myrtle Beach and North Myrtle Beach by the Corps of Engineers in 2008, an opportunity presented itself for renourishment of Arcadian Shores. The challenge was obtaining permits on relatively short notice and accomplishing the project within a narrow environmental window.

From start to finish in 11 months
Horry County retained CSE on 23 April 2007 to prepare the design, secure permits, issue plans to contractors, and oversee construction. On 30 March 2008, the last of the equipment was removed from the beach and the 6,000-foot-long project was ready for the tourist season. Going from initial planning to project completion in less than a year is the sort of challenge CSE has faced many times. The keys to this project’s success included:

  • Timely condition surveys and sand budgets for the area by CSE staff.
  • Identification of a new borrow area drawing on work by the US Geological Survey, Coastal Carolina University scientists, as well as our staff field team.
  • Timely review and issuance of permits by state and federal officials.
  • Efficient execution of construction by the contractor, Great Lakes Dredge & Dock Company, operating under an exceedingly narrow environmental window for hopper dredging.

[caption id=”attachment_38″ align=”alignright” width=”274″ caption=”Beach construction at Arcadian Shores (19 March 2008)”]Beach construction at Arcadian Shores (19 March 2008)[/caption]

Project Summary
The $4 million Arcadian Shores project placed ~316,000 cubic yards between Singleton Swash and the Apache Campground Pier. The new beach added nearly 200 feet of width and included realignment of the swash to mitigate downcoast erosion.

Construction was via two hopper dredges, Dodge Island and Padre Island, using a recently discovered deposit 1-3 miles offshore of the project area.  Building on a reconnaissance survey by Coastal Carolina University, CSE obtained 56 borings using our in-house coring system and confirmed sediment quality to below-operational depths. The high density of cores allowed us to select dredging corridors having the most compatible sediments for the beach while avoiding cultural resources, hard bottom, and ongoing monitoring by state resource agencies.

Hopper Dredge Advantages & Disadvantages
Prior studies along the central Grand Strand of South Carolina indicated that the best sand tends to be found in isolated thin sheets overlying an ancient offshore erosional surface. Such deposits are best suited for hopper dredges which excavate by sweeping thin layers off the bottom. Natural resource officials in the Carolinas generally favor hopper dredges because they tend to leave undisturbed areas for “recruitment” of benthic organisms. Hopper dredges cut narrow, shallow furrows rather than broad, deep holes in the bottom. The latter sometimes infill with finer material, thus changing the bottom characteristics.

The environmental advantages of shallow cuts via hopper dredge are offset by disadvantages during construction. Hopper dredges pose more of a threat to sea turtles than cutterhead dredges. As a result, work is severely restricted to just a handful of cold-water months under federal regulations. For Arcadian Shores, the allowable construction window was January through 31 March.

Close Timing for the Project’s Completion
CSE’s project team, led by Bill Forman and Doug Dusini, worked closely with county staff to secure permits just in time for winter construction. While the last permit reviews were in progress, CSE prepared final plans and bid packages for the project. As an example of extraordinary timing and coordinating, the following schedule was met.

1 February 2008 Plans available to contractors
28 February 2008 State permit issued
7 March 2008 Contract issued
6 March 2008 Federal permit issued
11 March 2008 Construction starts
28 March 2008 Construction ends
31 March 2008 Environmental window for construction ends

While such close timing is not CSE’s favored way of accomplishing projects, we are confident all the beach users and property owners along Arcadian Shores are happy at the outcome. With a much wider beach in place, they are less vulnerable to storms and the new beach can accommodate many more beach goers than before.

[caption id=”attachment_58″ align=”alignright” width=”300″ caption=”The renourished beach at Arcadian Shores after project completion. “]The renourished beach at Arcadian Shores after project completion. [/caption]

Performance Prediction
People ask how long the new beach will last? CSE predicts “well over ten years” based on the relatively low erosion rates along South Carolina’s Grand Strand and the experience after the initial nourishment in 1998. At the start of the 2008 project, there were 40-60 feet of storm berm remaining from the first project. So the first nourishment gave a head start to the second, ten years later. This trend is being repeated at other Grand Strand beaches under the federal 50-year project. Renourishment at ~10 year intervals is not only replacing eroded sand, it is widening the beach even further, keeping seawalls buried, and allowing a buffer of dunes to soften the shoreline between the ocean and developed property.

Acknowledgments

Owner:    Horry County SC (c/o Steven Gosnell, Director, Public Works)

Engineer:    CSE Columbia SC (c/o Bill Forman Jr., PE, Doug Dusini, Philip McKee, Trey Hair, and Dr. Tim Kana)

Contractor:    Great Lakes Dredges & Dock Company (c/o Steve Auernhamer)

CSE Columbia moves into a new office

After 13 years on Devine Street, CSE moved to new quarters at 160 Gills Creek Parkway on August 1st. The new office gives us some much-needed space so we can accommodate new staff and store all our field equipment (which has expanded as our firm has grown). Watch for an announcement of our open house later in fall 2007. (It will take us a couple of months to unpack over 20 years’ worth of reports and archives from our 400+ projects over the years.)

[caption id=”attachment_138″ align=”aligncenter” width=”320″ caption=”CSE Columbia\’s new office”]CSE Columbia's new office[/caption]

Our phone numbers and normal mailing address remain the same. Overnight shipping address changes to 160 Gills Creek Parkway Columbia SC 29209.

Thank you for your patience earlier in August as we made the move and temporarily lost communication with you.
